January Malibu Update
Posted by Kelcey Davis on 1/25/2021The New Building (administration, library, classrooms and labs) is really taking shape. Work is continuing with:
- Solar Panel Installation
- Automated locking System installation
- Continued touch-up painting on interior & exterior areas
- Elevators acceptance by the State Elevator Inspector
- Sun shade installation
- Concrete walkways placement around building
The District had occupied Building A on December 8,2020 with administration, staff and teachers that are currently resolving issues relate to FF&E and with the Building Systems (punch list).
Building D (Demolition)
Artificial turf installation along with concrete retaining walls, concrete steps are being placed and concrete walkway placement on east side of Building D footprint has been completed.
Building E
Punchlist items are 96% complete as of now. Final projects include soil excavation and form work for new concrete walkways and an ADA ramp on the Parking lot.
Morning View Drive Roadwork

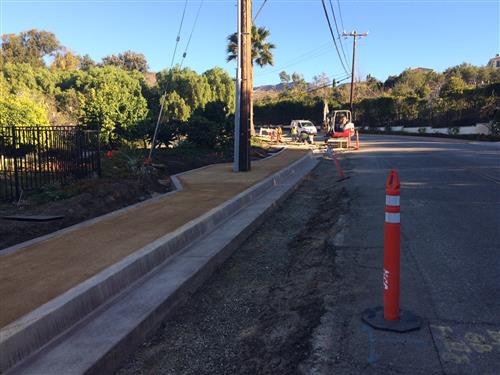

Improvement Work continues on Morning View Drive Roadwork Improvement. Placement of concrete driveways, curbs and gutter at Church site location across from the MHS campus has been completed.
Campus Security Camera Installation
The installation of new security camera placement around MHS & Juan Cabrillo Campus has been completed.
-
New Building is a Modern Education Environment
Posted by Kelcey Davis on 1/15/2021The new Administration, Library and Classroom Building is on track to be ready for occupancy during the 2021 spring semester. As you’ll see in some of these photos, it is beginning to look like the modern educational environment we planned. The Facility District Advisory Committee was recently given a tour.
Above is one of the new science classrooms in the new building on campus.
The library is coming along. It offers natural light, thoughtful and flexible furniture, conference rooms, and an excellent resource for the students. The furniture in the library is conducive to collaboration and can be reconfigured for different-size groups.The building's solar panels can be seen from below. These solar panels are a welcome addition to the new building and will help us achieve our district sustainability goals.
-
Staff Moves Into New Classroom, Library and Admin Building
Posted by Chris Clonts on 1/8/2021 4:00:00 PMThe new Administration, Library and Classroom Building is fully furnished and complete. Staff has moved in and is working out of the new building, which will welcome students as soon as pandemic conditions make it safe. Take a look at these great interior spaces!
Meanwhile, architects are designing Phase 1 of the Board-approved campus plan, which will eventually bring a new high school building, a performing arts center to be shared by middle and high schools, improved traffic flow on Morning View Drive and more.
-
MMHS Construction Update: New Building on Track for Spring Opening
Posted by Chris Clonts on 9/4/2020 6:00:00 AMThe new Administration, Library and Classroom Building will not be ready to open for the fall of 2020. The District encountered delays related to approval of the roofing system, street work and availability of certain materials. They are now on track to be complete during the fall of 2020 and ready for building occupancy during the 2021 spring semester.
Architects are designing Phase 1 of the Board-approved campus plan, which will eventually bring a new high school building, a performing arts center to be shared by middle and high schools, improved traffic flow on Morning View Drive and more.
-
MMHS Construction Update: Middle School Building almost ready
Posted by Chris Clonts on 8/2/2019 11:15:00 AMMIDDLE SCHOOL BUILDING
- The building (above), comprising 12 classrooms and three sets of boys/girls restrooms, is 90% complete.
- Carpet and tile were installed, as was adaptable furniture (shown at left) such as multi-configuration desks, chairs, cabinets, ceiling-mounted video projectors and whiteboards.
- The elevator tower is 80% complete, and the elevator cab is scheduled to arrive next week.
- The final exterior walkways, seat walls, landscape, and exterior painting are in progress and should be complete by the scheduled ribbon cutting (August 13 at 12:30 p.m.).
ADMINISTRATION BUILDING

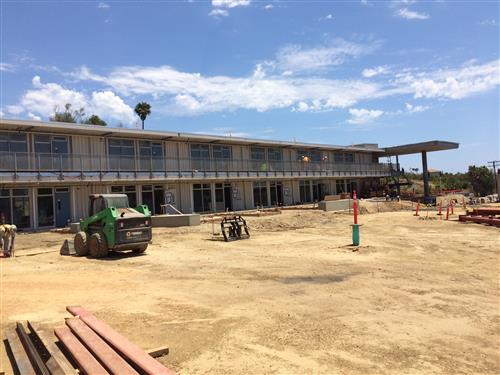

- This new building, shown here (Middle School Building is on the right), is progressing rapidly, as many main structural components are now in.

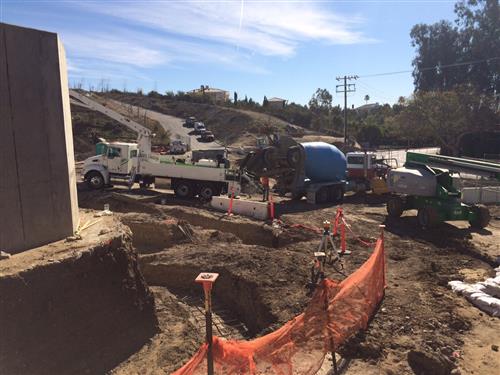

All vertical concrete walls have been poured and completed. - The concrete slab on grade for segment B of the new building has been poured.

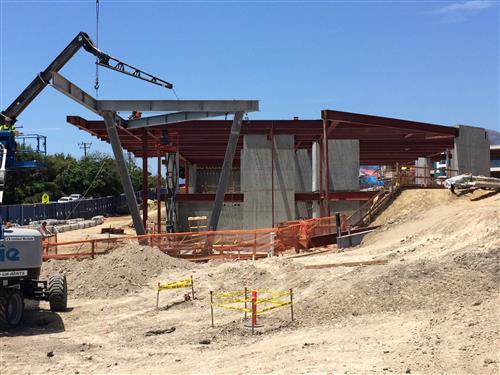

- Structural steel has been delivered to the site and nearly all of the steel for one segment of the building has been erected and bolted in place.
- The metal deck for the second floor has been placed. The work to place lightweight concrete will begin in a few weeks.

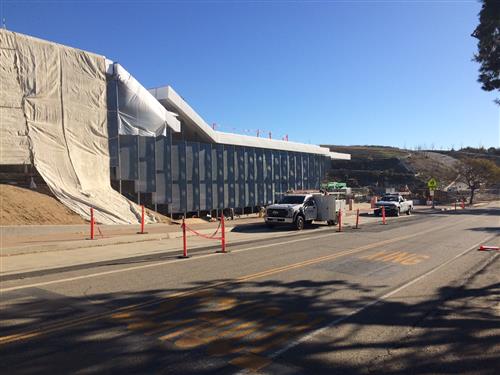

- The building (above) is really taking shape with the new "V" columns installed at the main entrance, creating quite a view as one arrives to the site via Morning View Drive.
-
Malibu High School
Posted by Maryanne Solomon on 5/24/2019- Surveying the fire lane and installing underground storm drain.

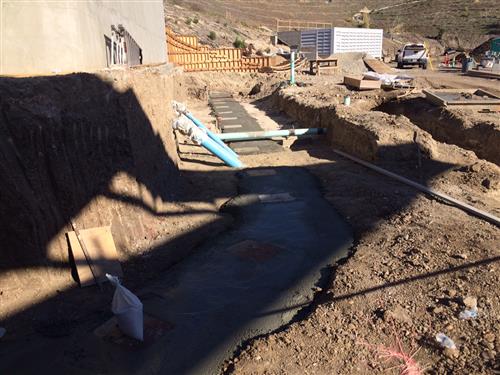

- At new Admin/Library Building, we’re tying-in sewer lines and installing underground conduit.
- Pouring concrete on vertical walls of a portion of admin building (bottom photo), and framing walls on the other segment of the building.
- Middle School Building (top photo): Installing fire riser and low-voltage electrical lines, a handrail on the second floor, and restroom finishes.
- Installation continues of handrail on the second floor and restroom finishes.
- Elevator tower roofing taking place. Also installing drywall within elevator tower.
